Villa renovation in Arabian Ranches — planned around the approvals.
In Arabian Ranches, any villa alteration needs an Emaar NOC first, applied for on the arabianranches.ae portal, then a DDA Building Modification permit, and a completion inspection before Emaar refunds the deposit. Interior painting and regular maintenance need no NOC. This page covers the original Arabian Ranches, with a note on Arabian Ranches 2 and 3.
Last reviewed 1 Oct 2026Sources and dates

At a glance
Arabian Ranches, at a glance.
- Community management
- Emaar Community Management (ECM)8
- NOC issued by
- Emaar, through the Alterations tab or Home Modifications3
- Where to apply
- arabianranches.ae, signing in through Sakani; the Emaar One app takes service requests8
- Sub-communities
- 15, from Al Reem townhouses to Mirador and the Golf Villas6
- Handover era
- First residents from 200413
- Also here
- Arabian Ranches 2 and 3 follow the same Emaar NOC list4
Approvals · Arabian Ranches
How an Arabian Ranches renovation is approved, step by step.
Emaar reviews the villa alteration first; DDA approves the design, issues the permit and signs off completion. Neighbours are told before noisy work begins.
Step 01 / 06
Survey the villa, not the brochure
- Issued by
- Fajr Interiors
- Where
- Your villa
- You receive
- As-built drawings, the scope, what needs an NOC
What to know
Twenty-year-old villas have usually been altered. We draw what is there, because the Emaar submission shows the house as built, and interior painting, AC cleaning and sanitary or electrical repairs need no NOC.3
Step 02 / 06

Emaar NOC
- Issued by
- Emaar
- Where
- arabianranches.ae → Alterations, or Home Modifications
- You receive
- The Emaar NOC for the villa
What to know
ECM lists carport extensions, pergolas, pool renovation and any villa alteration as needing the NOC, and recommends notifying neighbours before works start.3
Step 03 / 06


DDA Building Modification – Design
- Issued by
- DDA; the consultant applies
- You receive
- Stamped, approved drawings
What to know
Where walls, structure or services change. A Dubai Civil Defence NOC is added where fire and life safety systems change.10
Step 04 / 06

DDA Building Modification – Permit
- Issued by
- DDA; the contractor applies
- You receive
- The building modification permit
What to know
Renewable in three-month steps for up to a year from issue, which matters for a phased build around a family.11
Step 05 / 06

ECM contractor entry permit
- Issued by
- Emaar Community Management
- Where
- ecmpermits.ae
- You receive
- An entry permit for Arabian Ranches and this contract
What to know
ECM runs video guides for contractor registration in English, Arabic, Hindi and Bangla.8
Step 06 / 06



Completion, then the deposit
- Issued by
- Emaar, then DDA
- Where
- arabianranches.ae; DDA Building Modification – Completion
- You receive
- Emaar’s inspection approval, the DDA completion certificate and the deposit refund
Read the detailClose the detail
Arabian Ranches villas date from the mid-2000s, and many briefs here are remodels: kitchens opened, bathrooms rebuilt, wiring and plumbing renewed. Those reach the DDA design and permit steps, not just the Emaar NOC. Because the permit can be renewed in three-month steps, a longer build can stay covered by one permit.11
The ECM guidelines page asks for licensed contractors, certifications in place before work starts, and a clean community during and after the works; failing the architectural guidelines brings a notice of violation with rectification at the owner’s cost.7
Documents
What goes into an Arabian Ranches submission.
Emaar’s checklist for the NOC and DDA’s for design, permit and completion. We build both from one survey.
Concept visualisationYou provide
- Title deed and owner ID
- Photos of the rooms to change1
- Any earlier NOCs for the villa
We prepare
Read the detailClose the detail
In older villas the walls we want to remove are the ones the checklist asks about. Opening a closed kitchen into the family room is the most requested change in Arabian Ranches; if the wall carries load, the structural calculations go into the DDA design file with the drawings.10
Fees and timelines
Published fees and timelines for Arabian Ranches.
The figures Emaar and DDA publish, each dated. Confirm every one at application.
The villa programmeAround 12 months, brief to handover
| Item | Figure | Timing | Charged by | Source |
|---|---|---|---|---|
| Emaar NOC · review fee | AED 500 | Paid when you apply; non-refundable | Emaar | As published by Emaar, April 2022. Source 1. Confirm at application. |
| Emaar NOC · approval fee | AED 1,000 minor works · AED 2,000 major works | 3 business days from a complete submission; the review fee is deducted | Emaar | As published by Emaar, April 2022. Source 1. Confirm at application. |
| Landscaping, paving or external paint NOC | AED 100 | 2 business days | Emaar | As published by Emaar, April 2022. Source 1. Confirm at application. |
| Security deposit | AED 5,000, refundable | Refunded after the completion inspection; claim within two years of payment | Emaar | As published by Emaar, April 2021. Source 2. Confirm at application. |
| Added GFA or BUA on an extension | Charged; the rate is not published | Quoted by Emaar with the application | Emaar | As published by Emaar, April 2022. Source 1. Confirm at application. |
| DDA Building Modification – Design | AED 1,500 + AED 10 Knowledge + AED 10 Innovation Dirham | 5 working days; approved design valid 6 months | DDA | As published by DDA, September 2026. Source 10. Confirm at application. |
| DDA Building Modification – Permit | AED 1 per sq ft of added or relevant BUA + AED 20 | 2 working days; renewal AED 200 per 3 months, up to 1 year | DDA | As published by DDA, September 2026. Source 11. Confirm at application. |
| DDA Building Modification – Completion | No fee for a standard submission | 3 working days | DDA | As published by DDA, September 2026. Source 12. Confirm at application. |
Read the detailClose the detail
Arabian Ranches renovation pages online quote “administration fees”, NOC costs in the tens of thousands and deposits of up to AED 10,000. None of those appears in Emaar’s factsheet, which publishes a review fee, an approval fee and a deposit, and states that added area is charged without giving the rate.1 We work from the published figures and ask Emaar for the rest in writing.
The deposit amount is from Emaar’s April 2021 factsheet.2 DDA’s pages are undated and shown as read in September 2026.
What’s allowed
What Arabian Ranches owners can change, and what stays.
ECM’s Arabian Ranches FAQ and guidelines set a stricter exterior line than most communities. Each chip links to its source.
Allowed without an NOC4
Needs approval first7
Read the detailClose the detail
“Any external modifications that will change the aesthetics of the villas are not permitted” is ECM’s wording for Arabian Ranches, and its guidelines list exterior doors, windows and window coverings as prohibited.3 That makes the interior the place where an Arabian Ranches villa changes.
Emaar assesses extensions case by case, Al Reem and Palmera townhouses included. Our 2026 approval in The Springs capped the extension at about 10% of the existing BUA, with other conditions.14 Emaar’s 2022 factsheet listed townhouse extensions as restricted;1 an extension is drawn and put to Emaar before it is priced.
Rules on site
Rules on site in Arabian Ranches.
The Arabian Ranches I villa rulebook, uploaded in December 2025, sets the hours below. ECM also asks owners to warn neighbours before noisy works.
The working daySource 5
- Monworks
- Tueworks
- Wedworks
- Thuworks
- Friworks
- Satworks
- Sunno works
Neighbours first
ECM recommends notifying neighbours and keeping noisy works to permitted hours.3
Entry permits
Contractors enter only with an approved ECM permit.5
Deliveries
48 hours’ notice; Monday to Saturday, 10:00–13:00 only.5
Mature trees
No tree comes out without written permission.5
Debris and dust
Removed at the owner’s cost; dust contained, common areas protected.5
Penalties
A notice of violation; rectification and fines charged to the owner.7
Read the detailClose the detail
Some Arabian Ranches renovation pages give Saturday-to-Thursday hours with Fridays off, and ECM’s contractor portal gives 08:00–17:30.9 The December 2025 rulebook is the newest primary source and names Sundays, so we follow it and confirm at mobilisation. Ramadan hours are not stated.
Villa types
Arabian Ranches sub-communities, and the work each usually needs.
ECM lists 15 sub-communities, each with its own style: Spanish, Portuguese, Arabic, Santa Fe and contemporary.
Townhouses, terraced
Al Reem
- Bedrooms
- 2–3 bed
- Handover
- From 200413
Typical renovationKitchens and bathrooms; an extension goes to Emaar case by case.
Duplex villas
Palmera
- Bedrooms
- 3–4 bed
- Handover
- From 200413
Typical renovationGround floor opened; services renewed; any extension assessed by Emaar.
Contemporary detached villas
Saheel
- Bedrooms
- 3 and 5 bed
- Handover
- From 200413
Typical renovationFull remodels with new MEP; gardens and pools redrawn.
Portuguese-inspired duplex villas
Alvorada
- Bedrooms
- 3–5 bed
- Handover
- From 200413
Typical renovationKitchens opened, bathrooms rebuilt, joinery renewed.
Spanish-inspired villas
Mirador and Mirador La Colección
- Bedrooms
- 4–7 bed
- Handover
- From 200413
Typical renovationWhole-house work at scale, often phased by floor.
Duplex villas, traditional Arabic
Al Mahra
- Bedrooms
- 4–7 bed
- Handover
- From 200413
Typical renovationMajlis and family rooms replanned; stone and lighting renewed.
Read the detailClose the detail
The other sub-communities are Alma, Golf Villas, Hattan, La Avenida, Polo Homes, Savannah, Terranova and Aseel.6 Gulf News reported construction under way in May 2004, with first residents expected that year.13
Arabian Ranches 2 and 3 are separate communities on the same developer route; ask us about yours. ECM’s Arabian Ranches III FAQ carries the same NOC list and exterior prohibitions as the original Ranches, so the route on this page applies there too.4
Common projects
What Arabian Ranches villas usually need.
Villas from the mid-2000s: services, kitchens and bathrooms first, finishes second.

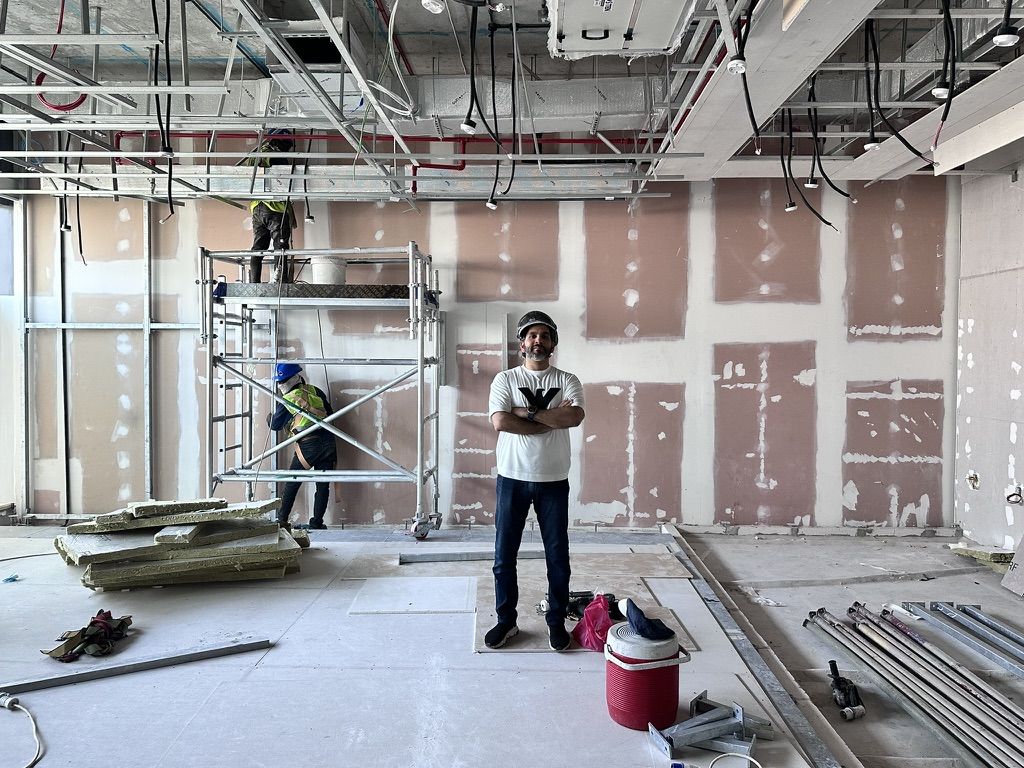

Original AC and MEP
Ducting, wiring and plumbing from the first build are near the end of their life. We renew them with the ceilings open, once, rather than patching room by room.

Closed kitchens, opened
The most requested change here. The wall often carries load, so it is checked, drawn and approved before it comes down.

Dated bathrooms
Stripped to the screed with the waterproofing renewed, not tiled over.
- Mature gardens
Mature gardens and trees
Twenty years of planting sits where pools and terraces would go. Trees stay unless ECM agrees in writing.5
- Exterior fixed
Doors and windows stay
ECM prohibits changes to exterior doors, windows and window coverings.7 New light comes from inside: reveals, joinery and ceilings.
Living through it
Where an Arabian Ranches household lives during the build.
For many Arabian Ranches owners the first question is where the family lives while the works run. The answer is the same for every scope: elsewhere. With civil works under way a villa is not safe to live in, so Fajr does not take on renovations with the family in residence. The build runs 6–8 months on a whole villa, and we confirm the dates at the first visit, before you plan a lease.
Design renders
Designed as one house, even when it is built in phases.
Fajr Interiors design renders, not photographs of an Arabian Ranches villa. A phased build is still designed as one house, so a room finished last matches the rooms handed back first.

RenderLiving corner, fluted panels and a triptych
RenderDouble-height dining under a sculptural chandelier
RenderThe dining table, seen from the landing
RenderMedia wall with a linear fire and walnut shelving
Renders, not photographs. Tap a render to enlarge it.
Villa 47 Fairways, a finished villa in Dubai Hills →Cost
What decides the number for an Arabian Ranches villa.
Villa renovation in Dubai runs AED 420–1,400 per sqft of built-up area, and our villa budgets start from AED 1M. In Arabian Ranches the renovation type, the built-up area and the finishes decide where a villa lands; phasing adds calendar time more than cost.
Arabian Ranches FAQ
Before you renovate in Arabian Ranches.
Villa renovation FAQ — Arabian Ranches, Dubai.
What Arabian Ranches owners search before a survey, answered from ECM’s and DDA’s own pages.
01Do I need a permit to renovate my villa in Arabian Ranches?
Yes, for any alteration. ECM’s Arabian Ranches FAQ says interior painting and regular maintenance, including AC cleaning and sanitary or electrical repairs, need no NOC. Everything else goes to Emaar first through the arabianranches.ae portal, then to DDA for the Building Modification design and permit where the works require them.
02Who issues the building permit in Arabian Ranches?
The Dubai Development Authority, after the Emaar NOC. The consultant applies for DDA Building Modification – Design and the contractor for the Building Modification – Permit. Dubai Civil Defence joins only where fire and life safety systems change, and DDA signs off with a completion certificate at the end.
03How long does Emaar take to approve a modification in Arabian Ranches?
Emaar’s factsheet gives three business days for minor and major works and two for soft landscaping or external painting, from a complete submission. Those are published targets; confirm them at application. DDA publishes five working days for design approval and two for the permit.
04Can I change the exterior of my Arabian Ranches villa?
Very little. ECM says external modifications that change the villa’s aesthetics are not permitted, and its guidelines prohibit changes to exterior doors, windows and window coverings. Pergolas, carports and shade can be approved in materials matching the villa. The interior is where an Arabian Ranches villa changes.
05Can I extend my Al Reem townhouse?
Possibly. Emaar assesses townhouse extensions case by case, so an Al Reem extension is drawn and put to Emaar before it is priced. On our 2026 Springs approval Emaar capped the extension at about 10% of the existing BUA, with other conditions. We plan the replanned ground floor alongside, so you choose with Emaar’s answer in hand.
06What are renovation working hours in Arabian Ranches?
The Arabian Ranches I villa rulebook, uploaded in December 2025, allows construction from 10:00 to 13:00 and 15:00 to 17:00, Monday to Saturday. There are no works on Sundays or public holidays except emergencies, and bulk deliveries need 48 hours’ notice.
07How long does an Arabian Ranches villa renovation take?
Around 12 months from brief to handover: 4 weeks planning, 8 weeks design with the approvals in parallel, 6–8 months build and 2 weeks handover. A phased build that keeps part of the villa in use runs longer in calendar time, and the DDA permit can be renewed to cover it.
Sources
Sources, and when we last checked them.
Last reviewed 1 October 2026. Every rule, fee and time on this page is as published by the body named, on the date shown, except figures marked as from Fajr’s 2026 applications, which are first-hand estimates. Rules and fees change: confirm each at application.
All 14 sources, with linksClose the detail
Official sources
- Emaar, Home Modifications – Dubai factsheet, 2022, accessed 30 Sep 2026
- Emaar, Home Modifications fact sheet, 12 April 2021, accessed 30 Sep 2026
- Emaar Community Management, Home modifications FAQ – Arabian Ranches, accessed 30 Sep 2026
- Emaar Community Management, Home modifications FAQ – Arabian Ranches III, accessed 30 Sep 2026
- Emaar Master Community Rules – Villas – Arabian Ranches I, uploaded December 2025, accessed 30 Sep 2026
- Emaar Community Management, Communities – Arabian Ranches, accessed 30 Sep 2026
- Emaar Community Management, Guidelines – Arabian Ranches, accessed 30 Sep 2026
- Emaar Community Management, Digitalising your community living – Arabian Ranches, accessed 30 Sep 2026
- ECM Contractors Portal, contractor registration and entry permits, accessed 30 Sep 2026
- Dubai Development Authority, Building Modification – Design, accessed 30 Sep 2026
- Dubai Development Authority, Building Modification – Permit, accessed 30 Sep 2026
- Dubai Development Authority, Building Modification – Completion, accessed 30 Sep 2026
Villa-type references: property portals and press
- Gulf News, Construction begins on Arabian Ranches, 5 May 2004, accessed 30 Sep 2026
First-hand: Fajr Interiors projects and 2026 applications
- Fajr Interiors, our own 2026 applications: Emaar extension approval in The Springs and Nakheel committee estimates (first-hand, not an official schedule), as at 1 Oct 2026
Related
Other villa communities, and the guides.
Villa renovation · Arabian Ranches
Start your Arabian Ranches villa in the right order.
